Meadow Park Redevelopment Project

Redevelopment of Meadow Park is necessary to achieve resilience in response to increasing use levels and climate change outcomes. Additionally, park infrastructure is in need of replacement.

Overview

Meadow Park was constructed almost 40 years ago and has become one of Whistler’s most popular public outdoor spaces. With increasing pressures from visitation and environmental changes, it is essential to reinvestment in aging infrastructure to meet current programming requirements and opportunities.

A key focus will be the replacement of the ever popular spray park which is at the end of its useful lifespan and does not meet current Vancouver Coastal Health requirements or Whistler’s Water Conservation Bylaw.

Other proposed improvements include enhanced picnic areas and recreational space along the river’s edge, improved site circulation, reconstructed irrigation, and drainage system, formalized off-leash dog facility, and public art opportunities.

Status: Detailed design

The Meadow Park Playground and Splash Park detailed designs, known as Phase 1, have been completed. Designs were informed by community input received earlier in 2023, in addition to Open Voices engagement in 2019.

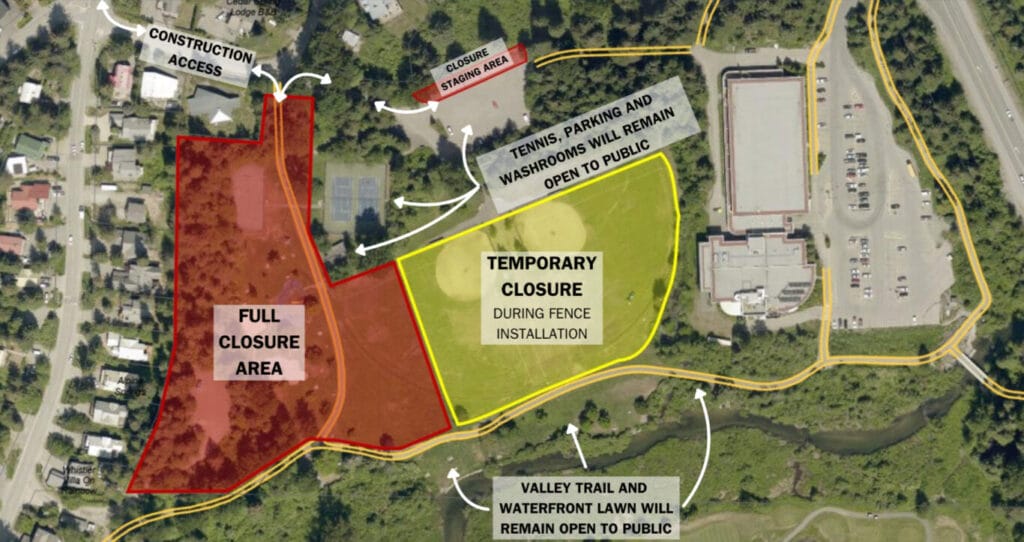

The playground, water park and fencing of one ball diamond will be part of Phase 1 construction beginning in Spring 2024. The RMOW plans to issue an RFP for this work in the winter, with the aim to begin construction in Spring 2024.

The ball diamonds will not be removed at this time. Only one diamond is planned to be fenced in for use as an off-leash dog. Once fenced, the ball diamond will remain functional for ball play.

Construction works are funded by the Resort Municipality Initiative Fund.

View the Detailed Designs

View the Meadow Park Engagement Summary (Part 2)

View the Meadow Park Master Plan presentation to Committee of the Whole

Scope of work

  • The final park master plan that can be delivered in a phased approach.
  • Design and construction of Area 1 ( initial build-out area) including playground and splash park.

Engagement

  • First Nations and public engagement are part of this project.
  • Relevant Committees of the Council will be engaged as the project advances.
  • Initial public engagement feedback and data were collected through the 2019 Outside Voice Parks Master Plan. Further public engagement will take place throughout the project.
  • Engagement opportunities will be announced in the Pique Newsmagazine and the weekly Whistler Today municipal e-newsletter.

Timeline

  • Schematic design – fall 2022
  • Detailed design, construction documentation, permitting, tendering – 2023
  • Construction – Anticipated April 2024
  • Completion – Anticipated November 2024

Funding

The Meadow Park Redevelopment project is 100% funded by the Resort Municipality Initiative (RMI). Resort Municipality Initiative | Resort Municipality of Whistler
